Report #: Q0288
The purpose of the Project Material Scheduling Summary is to provide visibility into the overall state of Materials, as well as Subcontract Items, on a Project and to assist with the forecasting and scheduling of those Materials

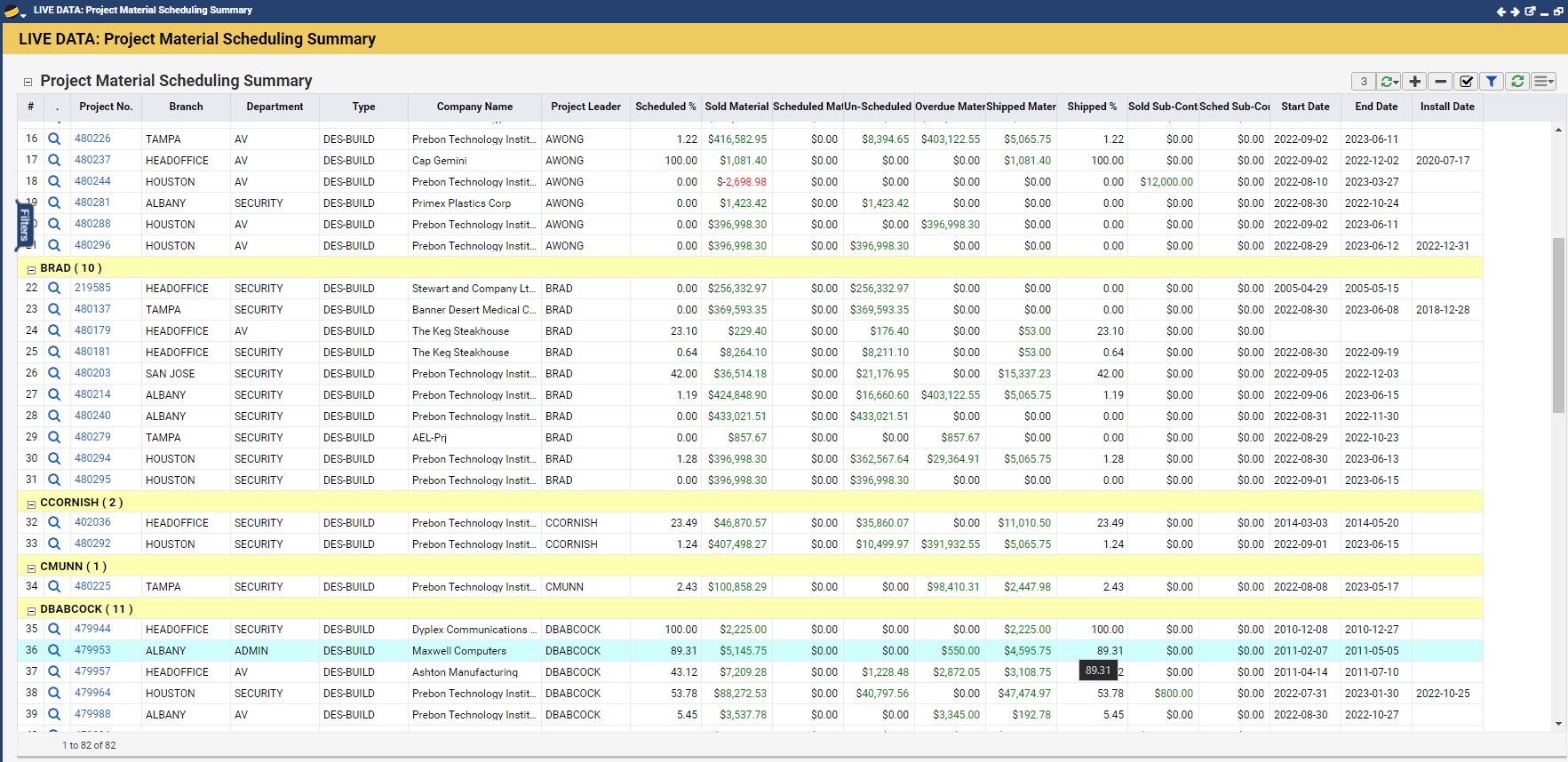

Path: Live Data > No Category > Project Material Schedule Summary
Key Data Used:
- Order Line Items
- Line Item Request Dates
- Project GL Entries
This report shows a Project-by-Project breakdown of Materials sold, scheduled, overdue and shipped. It also shows sold and scheduled Subcontractor Items. This information can assist in Project forecasting
Sold Materials: The cost of all Materials sold on the Project. Equal to the Profit Tab’s Projected > Materials column
Scheduled Materials: The total value of all Materials with a Request Date, including Overdue Items
Schedule %: (Unshipped Material with a Req Date + “Shipped Material”) / “Sold Material.” Total Scheduled Values
Un-Scheduled Materials: The cost of all Material Items without an assigned Request Date, Ship Release Date and PO ETA. Looks for all three dates = NULL.
Overdue Materials: The cost of all Material Items that have not been shipped and the Request Date, Ship Release Date and PO ETA are in the past. Overdue Material compares the latest of these three values to today’s date
Shipped Materials: The cost of all Material Items that have been shipped
Shipped %: The percent based on the Shipped Materials divided by the Sold Materials
Sold Sub-Contract: The cost of all S type Items sold on the Project. Equal to the Profit tab’s Projected > Subcontractor column
Scheduled Sub-Contract: The cost of all S type Items with an assigned Request Date
For more information on other useful reports, check out our Sales and Operations Reports Webinar.
